Timeline of our progress

This is just a list with some picture of the stuff we have "completed" and are planning on tackling in the future. Go to the blog if you want specific details on stuff we've been doing.

GO TO EL BLOG

Schedule of work

Stuff we have "Completed"

1. Uproot life and move to foreign terrain

May 2022

Moved from Florida to SW Colorado

2. Purchase land

June 2022

44 acres of raw land, mostly juniper, pinion pine, and sage brush.

3. Power & Water

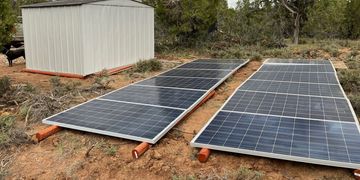

July 1, 2022

6500 Watt solar array (not on the ground anymore) and 2500 gallon partially buried cistern tank

4. Septic System

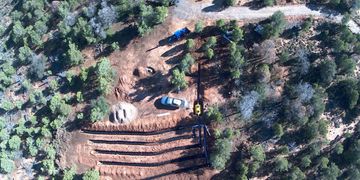

August 2022

0.5 acres of land cleared, 500 feet of trenches, 150hrs of digging on the backhoe... all to accomodate 2 people and an RV to take dumps.

5. Purchase Quonset Hut

August 2022

 40' wide x 44' long x 20' peak height from Durospan Steel.

6. Level the homesite

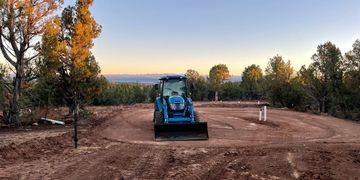

Sept. 2022

Mostly used dirt on the property and had a few trucks delivered. Many many hours on the tractor dragging the boxblade in circles.

7. Guest house delivered

Oct. 2022

Purchased a 500 bbl drill water tank to repurpose as a Father-in-law suite. 14' Diameter x 20' tall, +15000lbs of steel. FB Marketplace deal of the year.

8. Dig Foundation Trenches & Rebar Bending

Oct. 2022

The Dawson Family including Max, Lily & Wini showed up for week long rebar bending party. Couldnt have done it without ya'll!

9. Foundation Form boards

Nov. 2022

Installed form boards up to final grade above the foundation trenches. Lined everything with plastic to prevent concrete spills & preserve the wood

10. Pour concrete foundation

Nov 15, 2022

40 cubic yards (4 full trucks) poured in 2 hours by 2 rookies, it turned out great... ish

11. Erect the quonset hut garage

Nov 2022

30' x 40' x 15' Galvanized poles & canvas tarp, Installed very sketchily in 2 days with 2 people. A perfect place to organize & store the materials we had laying around like the set of Sanford & Son.

12. First Ski Trip

Nov 24, 2022

Spent Thanksgiving day on the mountain shredding and ate a buffet at the lodge.

More will be added as we "complete" things on our TODO list below.

Todo list

WORK ON THE HOUSE

Erect the quonset hut arches

21 arches made of 7 panels each, and over 4500 nuts & bolts

Underslab plumbing

Backfill & grade with gravel

Backfill & grade with gravel


WORK ON THE PROPERTY

Build pond

Multi-leveled 0.5acre pond to retain runoff water from the ravine. Repurpose water for growing crops, animal use, swimming (summer), ice skating (winter)

Fence the property

Entire perimeter would be cool, more than likey it will be smaller paddocks

Remote operated gate

Gate for the easement road, and a gate and grand entrance for the main house driveway

Add a footnote if this applies to your business

  • Blog

Tierra de los Arcos

Copyright © 2024 Tierra de los Arcos - All Rights Reserved.

Powered by GoDaddy

This website uses cookies.

We use cookies to analyze website traffic and optimize your website experience. By accepting our use of cookies, your data will be aggregated with all other user data.

Accept
